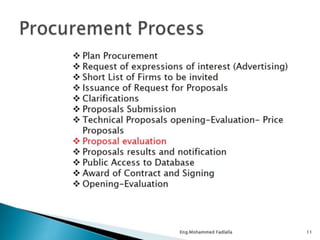

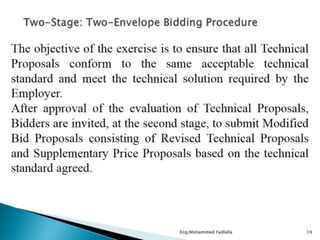

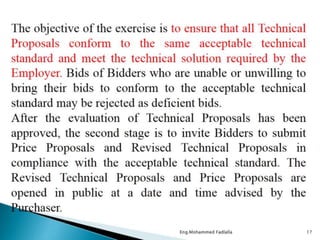

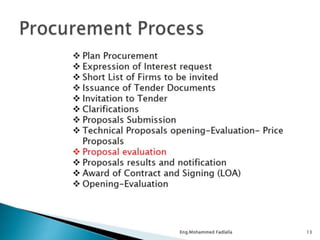

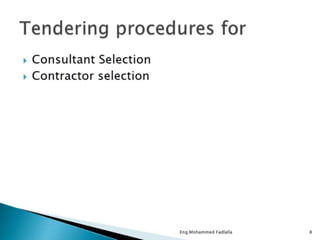

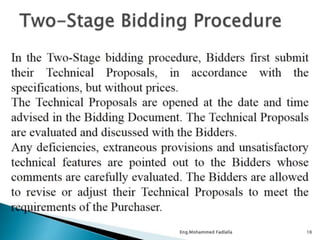

The document discusses various aspects of civil tenders and contracts processes in the Indian Railways. It defines civil tenders as the process where governments and institutions invite bids for project execution within a deadline. It notes that a contract is a defined legal agreement between the tendering authority and successful bidder. It also describes the different types of tenders like open, limited, special limited, and single tenders. Additionally, it provides details on tendering processes like notice inviting tenders, publication of tenders, tender committee formation, and earnest money deposits.
The document discusses various types of construction contracts and tendering processes. It defines a tender as an invitation from an owner to contractors to execute work at a specified cost and time. There are different types of tenders including open, sealed, limited, and single tenders. Key aspects of the tendering process include tender forms, documents, notices, evaluation criteria, acceptance procedures, contract documents, deposits, and measurements. Different types of construction contracts are also summarized such as lump-sum, item rate, percentage rate, cost plus, and turn-key contracts.

FIDIC is an international federation of consulting engineers established in 1913. It publishes standard form construction contracts known by the color of their covers, such as the Red Book. The document discusses the history and evolution of FIDIC contracts, describing various contract forms like the Red Book, Yellow Book, and Silver Book. It also discusses the roles of consulting engineers and the Consulting Engineers Association of India, the Indian affiliate of FIDIC.
The document discusses the various causes and factors contributing to construction disputes, including contract issues, financial aspects, and external factors. It examines different dispute resolution methods such as adjudication, expert determination, litigation, mediation, and arbitration, highlighting their advantages and disadvantages. Additionally, it emphasizes the importance of building information modeling (BIM) in preventing disputes and maintaining project efficiency.
This document provides an overview of construction contracting methods and contract types. It discusses the traditional Design-Bid-Build approach, as well as Design-Build, Turnkey, and Construction Management delivery methods. The major contract types covered are Lump Sum, Unit Price, Cost Plus, and variations like Cost Plus Fixed Fee and Cost Plus with a Guaranteed Maximum Price. For each, the document outlines the key characteristics, advantages, and disadvantages. The course appears to cover construction documents, contracting, bidding processes, and contract conditions over multiple lectures.
The document is the tender and contract conditions for the construction of a building in Liwan, Dubai. It includes instructions to tenderers on submitting the tender, requirements for site visits, and clarification of contract documents. The tender must include supporting documents such as proof of a site visit and a tender bond. The employer reserves the right to accept or reject any part of the tender. The tenderer is responsible for understanding all project requirements and conditions. No changes can be made to the tender documents except for filling in blanks.
The document details the fundamentals of contracts in civil engineering, outlining their legal nature, validity criteria, essential components, and various types of contracts such as lump-sum and cost-plus contracts. It also discusses arbitration, its advantages and disadvantages, as well as different types of arbitration like voluntary and compulsory arbitration. Key conditions of contracts and classifications are explained, emphasizing the importance of clear documentation and procedural integrity in contract management.
The document provides an overview of rate analysis in civil engineering, detailing the process for determining costs of various construction works, including factors such as material specifications, labor costs, and site logistics. It explains the concepts of lead and lift in terms of material transport and includes specific examples of cost calculations for different materials. The document also recommends several resources for further study on estimating and costing in civil engineering projects.

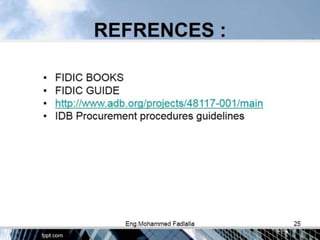

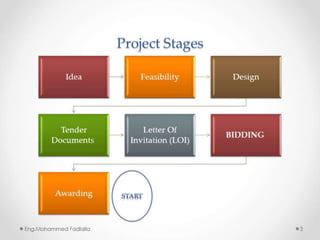

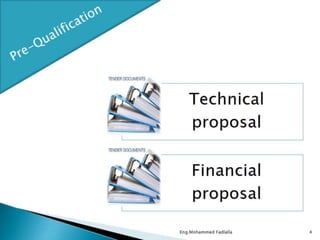

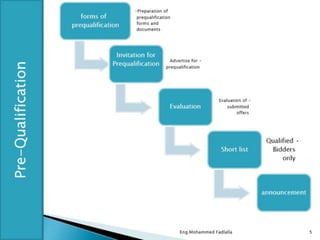

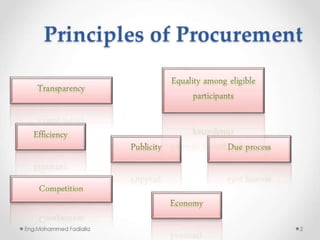

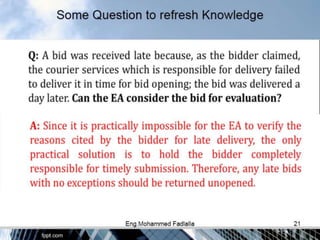

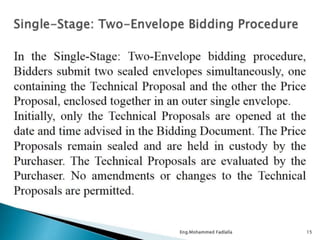

This document provides an overview of the tendering process and types of tenders. It discusses open tendering, selective tendering, and negotiated tendering. Open tendering allows any contractor to bid, while selective tendering pre-qualifies contractors. Negotiated tendering involves inviting a specific contractor. The document also describes tender documents, including cover letters, invitations to tender, terms and conditions, bills of quantities, drawings, specifications, and evaluation criteria.
This document discusses the design of an underpass. It begins with objectives such as reducing accidents and providing safe and hassle-free movement of vehicles and pedestrians. It describes the methodology, survey results of the existing junction, traffic count data, soil testing results, and design of the road, box culvert, and overbridge. It includes analysis of loads and moments on structural elements. Reinforcement details are provided. Cost estimation and conclusions that the underpass will maintain vehicle speed and reduce accidents are also summarized.
This document provides information on concrete mix design, including objectives, basic considerations, and the IS (Indian Standards) method for mix design. The objectives of mix design are to achieve the desired workability, strength, durability, and cost. Basic considerations include cost, specifications, workability, strength, durability, and aggregate grading. The IS method is then described in steps, including selecting target strength, water-cement ratio, air content, water and sand contents, cement content, and aggregate contents. An example application of the IS method is also provided.
Earnest money is a monetary deposit paid by bidders to show their sincerity and good faith in a project. It aims to prevent bidders from withdrawing their bids before the validity period ends. Standard earnest money amounts are 2% of the estimated project cost for works costing up to Rs. 10 crores, and 1% of estimated cost plus Rs. 20 lakhs for higher value projects. Earnest money is refunded once the contract is awarded, or forfeited if the bidder withdraws during the validity period. The document discusses earnest money definitions, forms, amounts, refund processes, and treatments under different scenarios.
Special concrete is used when special properties are more important than normal concrete properties. It is produced using chemical and mineral admixtures added to conventional concrete mixes. There are several types of special concrete including lightweight concrete, high strength concrete, fibre reinforced concrete, ferrocement, ready mix concrete, and others. Each type has specific properties and uses in construction where standard concrete is not suitable.
Extension of Time (EoT) in Construction Project presentationAyush Joshi
油
The document discusses extension of time (EOT) in construction projects. It outlines factors that can cause delays and qualify for an EOT, including weather, site conditions, design issues, and delays by owners or other contractors. It also summarizes requirements for applying for and approving EOTs according to standard contract forms and Nepalese law. Contractors must apply before the deadline and prove delays were outside their control. EOT approval depends on the length of extension needed and requires investigation by the owner. Liquidated damages may be assessed for contractor delays, but contracts also provide rewards for early completion.
This document discusses methods for determining soil bearing capacity from standard penetration test (SPT) numbers. It provides Meyerhof and Bowles equations that relate allowable soil bearing capacity (Qa) to SPT numbers (N) and footing parameters. It also gives examples of using the equations to calculate Qa for different soil and footing conditions.
What is construction management & its Benefits?maria_singh
油
Construction management encompasses the design and implementation of construction projects, focusing on planning, time, cost, and quality control. It involves five key phases: initiation, planning, execution, monitoring, and closure, with the aim of completing projects within budget and on schedule while managing risks and maintaining quality. Effective construction management optimizes resource use, enhances teamwork, and contributes positively to society by minimizing waste and ensuring timely project delivery.
The document outlines the concept of negotiated contracts in construction, emphasizing that they are awarded based on negotiations rather than tenders. It details different types of negotiated contracts, including cost plus percentage rate, cost plus fixed fee, cost plus fee profit sharing, and cost plus sliding fee contracts, along with their respective merits and demerits. The summary highlights the implications of each contract type on cost management and contractor efficiency.
This document provides an overview of the IRC method for designing flexible pavements according to IRC: 37-2012. It discusses the key considerations and calculations involved, including design traffic, subgrade properties like CBR and resilient modulus, material properties, and traffic data collection. The goal is to design a flexible pavement for a new four-lane divided national highway using the IRC guidelines and given traffic and material property data.
The document discusses price variation in works contracts. Price variation accounts for increases or decreases in item costs between the tender submission date and work completion date. Only major cost components like labor, steel, cement, and fuel are considered for price variation calculations. Formulas use price indices on the last tender date and work date to calculate cost variations on components. It is important to ensure like materials from the same manufacturers and locations are used in price variation analyses. Price variation may be paid quarterly and is designed to avoid cost uncertainties for contractors during long contracts over 6 months.
The document outlines a workshop on bridge design and structural engineering led by Dr. Naveed Anwar, focusing on various aspects including design processes, classification of bridge types, and recent trends in modeling. It emphasizes the importance of structural design to ensure safety, functionality, and aesthetic considerations in bridge construction. Additionally, it discusses the government's Central Expressway project in Sri Lanka and various engineering practices related to bridge systems and components.
The document discusses various aspects of contract and contract management for construction works. It covers topics such as types of contracts, tender documents, pre-bid meetings, evaluation of technical and financial bids, award of work, commencement of work, coordination issues, and determination/rescission of contracts. The key points are that contract management requires fulfilling obligations by both parties, coordination is essential for success, and timely decisions need to be taken if work is unsatisfactory or delayed.
Shear, bond bearing,camber & deflection in prestressed concreteMAHFUZUR RAHMAN
油
The document provides a detailed overview of prestressed concrete design, including definitions, types of shear forces, and various failure modes of prestressed beams. It also discusses the implications of bond mechanics, transfer of prestressing force, and factors influencing shear strength in prestressed concrete. Additional sections cover end zone reinforcement, camber, deflection, and methods for calculating deflection in prestressed systems.
Labour Laws and Financial Aspects of Construction Project _ Unit 3 _ Construc...Shrikant Kate
油
The document outlines essential labour laws and financial aspects of construction projects, highlighting laws such as the Workmen's Compensation Act 1923 and the Building and Other Construction Workers Act 1996. It covers the importance of these laws for worker protection, fair wages, and safety, while discussing financial management, including working capital, cash flow projections, and profit-loss statements. Additionally, it describes various sources of finance, the calculation of compensation in case of accidents, and the regulations for child labor and interstate migrant workers.
The document discusses various types of construction contracts, including lump sum, item rate, labour, material, percentage rate, cost plus, and turnkey contracts. It describes key elements that should be included in a construction contract agreement, such as a description of the work, payment procedures, completion dates, signatures of parties, and references to other contract documents like drawings and specifications. Disputes are typically resolved through arbitration according to the legal requirements in the contract documents.
FIDIC is an international federation of consulting engineers that publishes standard forms of contract. It was founded in 1913 and is headquartered in Geneva. Some of FIDIC's most well-known standard forms include the Red, Yellow, and Silver Books. The Red Book covers construction projects, the Yellow Book covers electrical and mechanical works, and the Silver Book covers EPC/turnkey projects. FIDIC contracts establish important procedures like priority of contract documents, the engineer's role, extensions of time, insurance requirements, and dispute resolution processes involving negotiation, mediation, and arbitration.
The document details the design considerations for rigid pavements, focusing on slab thickness and stress analysis, which includes factors such as flexural and temperature stresses. It outlines critical stress conditions, design procedures, and calculations needed for determining edge and corner stresses, as well as necessary joint types for efficient stress management. Key design principles include accommodating temperature and moisture changes and ensuring the pavement's durability against loading and fatigue.
The document discusses various aspects of contracts and arbitration in construction, emphasizing the importance of clear agreements between owners and contractors to ensure successful project completion within specified parameters. It outlines different types of contracts based on purpose and economic conditions, detailing specific contract types like lump sum and turnkey contracts, and discusses the selection and registration processes for contractors. The document also highlights arbitration as a preferred method of dispute resolution in construction projects, outline its procedures, advantages, and the characteristics of a good arbitration award.
This document provides an introduction to the subject of estimating and costing for the 2nd year intermediate vocational course in construction technology. It discusses key definitions like estimating, costing, and procedures for estimating. The importance of estimation and costing is explained. The data required for preparing an estimate like drawings, specifications, and rates is described. The document also discusses complete estimates, lump sum items, and work charged establishment. Measurement units for different construction items like earthwork, concrete, masonry, woodwork, and finishing works are listed with the applicable unit of measurement and payment.
Tender Process | A Complete Procurement GuideTender Process
油
The document provides a comprehensive overview of the tendering process used by governments and private sector organizations to invite and evaluate bids for projects and contracts. It details the steps involved in the tender process, the importance of compliance and value for money, and the differences between public and private sector tendering practices. Additionally, it emphasizes the need for businesses to understand their capabilities and effectively communicate their value propositions in order to succeed in competitive bidding.
The document discusses the tender process for construction projects. It involves project definition, selecting tenderers, issuing tender documentation, criteria for selection, calling for tenders, tender meetings, amendments, submission and closing, tender analysis of work experience, price, company finances and personnel, ongoing projects, and conformity to conditions. Selection criteria include conformity, capability, innovation, price and construction period. Tenders can be rejected for noncompliance, incomplete details, too high or low prices, too much work in progress, insufficient finances, or unsatisfactory records.
This document provides an overview of the tendering process and types of tenders. It discusses open tendering, selective tendering, and negotiated tendering. Open tendering allows any contractor to bid, while selective tendering pre-qualifies contractors. Negotiated tendering involves inviting a specific contractor. The document also describes tender documents, including cover letters, invitations to tender, terms and conditions, bills of quantities, drawings, specifications, and evaluation criteria.
This document discusses the design of an underpass. It begins with objectives such as reducing accidents and providing safe and hassle-free movement of vehicles and pedestrians. It describes the methodology, survey results of the existing junction, traffic count data, soil testing results, and design of the road, box culvert, and overbridge. It includes analysis of loads and moments on structural elements. Reinforcement details are provided. Cost estimation and conclusions that the underpass will maintain vehicle speed and reduce accidents are also summarized.
This document provides information on concrete mix design, including objectives, basic considerations, and the IS (Indian Standards) method for mix design. The objectives of mix design are to achieve the desired workability, strength, durability, and cost. Basic considerations include cost, specifications, workability, strength, durability, and aggregate grading. The IS method is then described in steps, including selecting target strength, water-cement ratio, air content, water and sand contents, cement content, and aggregate contents. An example application of the IS method is also provided.
Earnest money is a monetary deposit paid by bidders to show their sincerity and good faith in a project. It aims to prevent bidders from withdrawing their bids before the validity period ends. Standard earnest money amounts are 2% of the estimated project cost for works costing up to Rs. 10 crores, and 1% of estimated cost plus Rs. 20 lakhs for higher value projects. Earnest money is refunded once the contract is awarded, or forfeited if the bidder withdraws during the validity period. The document discusses earnest money definitions, forms, amounts, refund processes, and treatments under different scenarios.
Special concrete is used when special properties are more important than normal concrete properties. It is produced using chemical and mineral admixtures added to conventional concrete mixes. There are several types of special concrete including lightweight concrete, high strength concrete, fibre reinforced concrete, ferrocement, ready mix concrete, and others. Each type has specific properties and uses in construction where standard concrete is not suitable.
Extension of Time (EoT) in Construction Project presentationAyush Joshi
油
The document discusses extension of time (EOT) in construction projects. It outlines factors that can cause delays and qualify for an EOT, including weather, site conditions, design issues, and delays by owners or other contractors. It also summarizes requirements for applying for and approving EOTs according to standard contract forms and Nepalese law. Contractors must apply before the deadline and prove delays were outside their control. EOT approval depends on the length of extension needed and requires investigation by the owner. Liquidated damages may be assessed for contractor delays, but contracts also provide rewards for early completion.
This document discusses methods for determining soil bearing capacity from standard penetration test (SPT) numbers. It provides Meyerhof and Bowles equations that relate allowable soil bearing capacity (Qa) to SPT numbers (N) and footing parameters. It also gives examples of using the equations to calculate Qa for different soil and footing conditions.
What is construction management & its Benefits?maria_singh
油
Construction management encompasses the design and implementation of construction projects, focusing on planning, time, cost, and quality control. It involves five key phases: initiation, planning, execution, monitoring, and closure, with the aim of completing projects within budget and on schedule while managing risks and maintaining quality. Effective construction management optimizes resource use, enhances teamwork, and contributes positively to society by minimizing waste and ensuring timely project delivery.
The document outlines the concept of negotiated contracts in construction, emphasizing that they are awarded based on negotiations rather than tenders. It details different types of negotiated contracts, including cost plus percentage rate, cost plus fixed fee, cost plus fee profit sharing, and cost plus sliding fee contracts, along with their respective merits and demerits. The summary highlights the implications of each contract type on cost management and contractor efficiency.
This document provides an overview of the IRC method for designing flexible pavements according to IRC: 37-2012. It discusses the key considerations and calculations involved, including design traffic, subgrade properties like CBR and resilient modulus, material properties, and traffic data collection. The goal is to design a flexible pavement for a new four-lane divided national highway using the IRC guidelines and given traffic and material property data.
The document discusses price variation in works contracts. Price variation accounts for increases or decreases in item costs between the tender submission date and work completion date. Only major cost components like labor, steel, cement, and fuel are considered for price variation calculations. Formulas use price indices on the last tender date and work date to calculate cost variations on components. It is important to ensure like materials from the same manufacturers and locations are used in price variation analyses. Price variation may be paid quarterly and is designed to avoid cost uncertainties for contractors during long contracts over 6 months.
The document outlines a workshop on bridge design and structural engineering led by Dr. Naveed Anwar, focusing on various aspects including design processes, classification of bridge types, and recent trends in modeling. It emphasizes the importance of structural design to ensure safety, functionality, and aesthetic considerations in bridge construction. Additionally, it discusses the government's Central Expressway project in Sri Lanka and various engineering practices related to bridge systems and components.
The document discusses various aspects of contract and contract management for construction works. It covers topics such as types of contracts, tender documents, pre-bid meetings, evaluation of technical and financial bids, award of work, commencement of work, coordination issues, and determination/rescission of contracts. The key points are that contract management requires fulfilling obligations by both parties, coordination is essential for success, and timely decisions need to be taken if work is unsatisfactory or delayed.
Shear, bond bearing,camber & deflection in prestressed concreteMAHFUZUR RAHMAN
油
The document provides a detailed overview of prestressed concrete design, including definitions, types of shear forces, and various failure modes of prestressed beams. It also discusses the implications of bond mechanics, transfer of prestressing force, and factors influencing shear strength in prestressed concrete. Additional sections cover end zone reinforcement, camber, deflection, and methods for calculating deflection in prestressed systems.
Labour Laws and Financial Aspects of Construction Project _ Unit 3 _ Construc...Shrikant Kate
油
The document outlines essential labour laws and financial aspects of construction projects, highlighting laws such as the Workmen's Compensation Act 1923 and the Building and Other Construction Workers Act 1996. It covers the importance of these laws for worker protection, fair wages, and safety, while discussing financial management, including working capital, cash flow projections, and profit-loss statements. Additionally, it describes various sources of finance, the calculation of compensation in case of accidents, and the regulations for child labor and interstate migrant workers.
The document discusses various types of construction contracts, including lump sum, item rate, labour, material, percentage rate, cost plus, and turnkey contracts. It describes key elements that should be included in a construction contract agreement, such as a description of the work, payment procedures, completion dates, signatures of parties, and references to other contract documents like drawings and specifications. Disputes are typically resolved through arbitration according to the legal requirements in the contract documents.
FIDIC is an international federation of consulting engineers that publishes standard forms of contract. It was founded in 1913 and is headquartered in Geneva. Some of FIDIC's most well-known standard forms include the Red, Yellow, and Silver Books. The Red Book covers construction projects, the Yellow Book covers electrical and mechanical works, and the Silver Book covers EPC/turnkey projects. FIDIC contracts establish important procedures like priority of contract documents, the engineer's role, extensions of time, insurance requirements, and dispute resolution processes involving negotiation, mediation, and arbitration.
The document details the design considerations for rigid pavements, focusing on slab thickness and stress analysis, which includes factors such as flexural and temperature stresses. It outlines critical stress conditions, design procedures, and calculations needed for determining edge and corner stresses, as well as necessary joint types for efficient stress management. Key design principles include accommodating temperature and moisture changes and ensuring the pavement's durability against loading and fatigue.
The document discusses various aspects of contracts and arbitration in construction, emphasizing the importance of clear agreements between owners and contractors to ensure successful project completion within specified parameters. It outlines different types of contracts based on purpose and economic conditions, detailing specific contract types like lump sum and turnkey contracts, and discusses the selection and registration processes for contractors. The document also highlights arbitration as a preferred method of dispute resolution in construction projects, outline its procedures, advantages, and the characteristics of a good arbitration award.
This document provides an introduction to the subject of estimating and costing for the 2nd year intermediate vocational course in construction technology. It discusses key definitions like estimating, costing, and procedures for estimating. The importance of estimation and costing is explained. The data required for preparing an estimate like drawings, specifications, and rates is described. The document also discusses complete estimates, lump sum items, and work charged establishment. Measurement units for different construction items like earthwork, concrete, masonry, woodwork, and finishing works are listed with the applicable unit of measurement and payment.
Tender Process | A Complete Procurement GuideTender Process
油
The document provides a comprehensive overview of the tendering process used by governments and private sector organizations to invite and evaluate bids for projects and contracts. It details the steps involved in the tender process, the importance of compliance and value for money, and the differences between public and private sector tendering practices. Additionally, it emphasizes the need for businesses to understand their capabilities and effectively communicate their value propositions in order to succeed in competitive bidding.
The document discusses the tender process for construction projects. It involves project definition, selecting tenderers, issuing tender documentation, criteria for selection, calling for tenders, tender meetings, amendments, submission and closing, tender analysis of work experience, price, company finances and personnel, ongoing projects, and conformity to conditions. Selection criteria include conformity, capability, innovation, price and construction period. Tenders can be rejected for noncompliance, incomplete details, too high or low prices, too much work in progress, insufficient finances, or unsatisfactory records.
The document provides an overview of the tendering and bidding process. It defines key terms like tender, bid, proposal, and procurement methods. The tender process involves several steps - pre-tender activities, issuing the tender, tender evaluation, and awarding the contract. The bidding process map outlines various stages from announcement to awarding. The evaluation process consists of opening bids, examining them, requesting clarifications, evaluating and comparing bids, post-qualification, and recommending a winner. Key points of evaluation include checking for completeness, computational errors, and applying criteria to determine the lowest bidder.
The document discusses tendering processes for construction projects. It defines tendering as sending drawings and bills of quantities to contractors to receive price estimates. The purpose of tendering is to select a main contractor. Different procurement methods are described such as traditional where the client separately selects a designer and contractor, or design-build where one company handles both. Factors like project size and economic climate affect the tendering method choice. Students are tasked to discuss tendering purposes and objectives, and select a method for a given project by considering build type.
The document provides guidelines for entering tender notices into a database. It describes the important fields that should be included such as organization name and address, project details, estimated costs, bid bonds, tender values, deadlines, and notice types. Fields should be accurately completed and formatting checked. International and national tenders should be distinguished. Only tenders with sufficient deadline periods should be entered.
This document outlines information regarding a course on tender evaluation processes. It discusses the course objectives, which are to understand the tender evaluation process and criteria. It describes the typical evaluation process, which involves 6 stages from issuing the tender to acceptance of bids. It also outlines the criteria used, which differ based on project size. The document provides details on the typical information and documents required for bid submissions and evaluates the bidder. It describes the multi-stage evaluation process used to assess bids for compliance, completeness, financial capacity, and experience.
Recent Trends and Legal Developments You Should Consider in 2015: Part I Me...Winston & Strawn LLP
油
The document presents recent trends and legal developments in mergers and acquisitions (M&A) as of 2015, highlighting a significant increase in global deal volume in 2014, which reached $3.5 trillion. It discusses corporate inversion transactions, detailing the impact of U.S. tax rules on foreign mergers, and mentions new anti-inversion regulations introduced to mitigate tax avoidance strategies. Key insights include the rise in mega-deals and shifts in transaction structures, particularly in the context of U.S. companies engaging in cross-border M&A activities.
This document summarizes key points from the Asian Development Bank Procurement Guidelines regarding joint ventures, ADB review of procurement processes, misprocurement, references to ADB in contracts, and fraud and corruption. It discusses that firms can bid independently or in joint ventures, ADB reviews procurement to ensure compliance, misprocurement may result in canceled financing, contracts must reference ADB as the source of funding, and ADB has a zero tolerance policy for corrupt practices. It also provides that borrowers must prepare and obtain ADB approval of an initial 18-month procurement plan.
The document discusses regulations regarding preferential procurement in South Africa, specifically:
1) New regulations were approved in June 2011 to align the Preferential Procurement Policy Framework Act (PPPFA) and Broad-Based Black Economic Empowerment (BBBEE) Act, which will have wide-reaching implications.
2) The PPPFA takes effect in December 2011 and changes the point system to incorporate BBBEE compliance, using 80/20 and 90/10 preference point systems for procurement above certain thresholds.
3) The regulations provide guidance on evaluating bids, awarding contracts, subcontracting requirements, and establishing BEE strategies and preferential procurement processes.
Bangladesh is a South Asian country located between India and Myanmar. It has a population of over 148 million and Dhaka is its capital city. The national language is Bengali and over 90% of the population is Muslim. Key cultural aspects include clothing like saris and shalwar kameez, foods such as biryani and panta ilish, and festivals like Eid ul-Fitr and Pohela Boishakh. The national animal is the Royal Bengal Tiger and national bird is the doel.
The document provides guidance on how to successfully submit tenders for public sector contracts. It outlines the key steps including understanding the tender requirements, preparing supporting company documents, adhering to submission formats and deadlines, and evaluating feedback to improve future submissions. Regularly assessing performance and learning from experience are emphasized as important parts of the continuous tendering process.
Intro To Procurement And Tendering In Wales 際際滷setDawn_Rowley
油
This document provides an introduction to procurement and tendering processes in the public sector in Wales. It aims to increase understanding of the rules and processes behind public sector tendering. The objectives are to set tendering in its proper context and improve organizations' ability to identify, prepare for and respond successfully to tender opportunities. It covers the context of EU and UK public sector tendering, definitions, the tendering process, who it applies to and what types of goods and services it covers. It also discusses the changing political landscape in Wales and support available for the voluntary sector.
The document discusses Universal Design for Learning (UDL) principles aimed at improving accessibility in educational environments, emphasizing the importance of removing barriers for diverse learners. Key concepts include providing multiple means of engagement, representation, and action/expression for students. It also highlights various resources and technologies to support UDL implementation in K-12 education.
Le document traite des caract辿ristiques des circuits 辿lectroniques, notamment d'un amplificateur avec plusieurs 辿tapes. Il aborde les param竪tres fondamentaux tels que le temps de settling, la tension de sortie et les mod竪les math辿matiques associ辿s aux transistors. Les relations entre les diff辿rents composants et leurs comportements 辿lectriques sont 辿galement discut辿es.

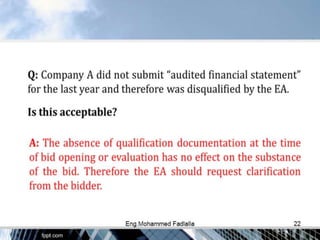

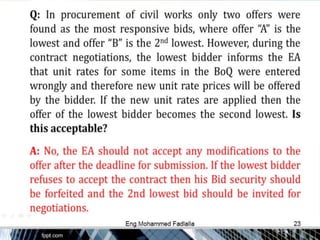

This document outlines the tendering process for a construction project. It includes sections on instruction to tenderers, qualification criteria, tender preparation and submission, tender opening and evaluation, and contract award. It provides details on project scope, eligibility, language and currency, submission deadlines, performance security requirements, and dispute resolution procedures. The bill of quantities specifies items for earthworks, concrete works, reinforcement, masonry, finishes, and facilities. Specifications cover materials, workmanship, and testing. Drawings include floor plans, sections, schedules and reinforcement details.
