PROJECT TITLE
AN INVESTIGATION OF FACTORS THAT LEAD
TO DELAYED FINAL ACCOUNT CONCLUSION
OF BUILDING PROJECTS IN MALAWI
CONSTRUCTION INDUSTRY
BY: LENSON MHANGO
(BQS/09/PE/016)
SUPERVISED BY: MR. C.I.M. CHIOCHA

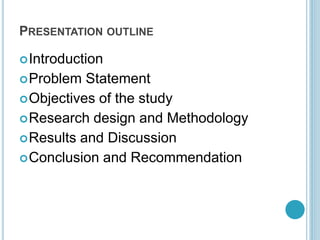

PRESENTATION OUTLINE
Introduction
Problem Statement
Objectives of the study
Research design and Methodology
Results and Discussion
Conclusion and Recommendation

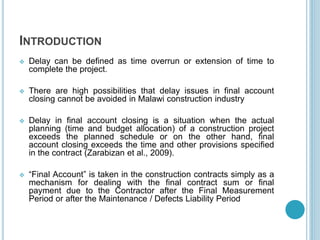

INTRODUCTION
 Delay can be defined as time overrun or extension of time to
complete the project.
 There are high possibilities that delay issues in final account
closing cannot be avoided in Malawi construction industry
 Delay in final account closing is a situation when the actual
planning (time and budget allocation) of a construction project
exceeds the planned schedule or on the other hand, final
account closing exceeds the time and other provisions specified
in the contract (Zarabizan et al., 2009).
 Final Account is taken in the construction contracts simply as a
mechanism for dealing with the final contract sum or final
payment due to the Contractor after the Final Measurement
Period or after the Maintenance / Defects Liability Period

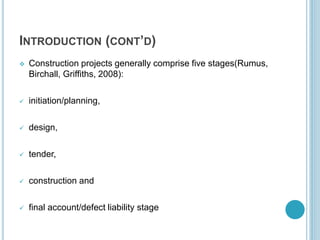

INTRODUCTION (CONTD)
 Construction projects generally comprise five stages(Rumus,
Birchall, Griffiths, 2008):
 initiation/planning,
 design,
 tender,
 construction and
 final account/defect liability stage

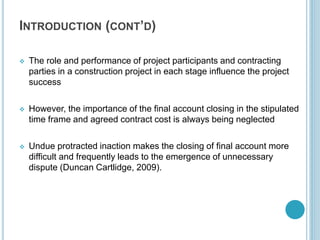

INTRODUCTION (CONTD)
 The role and performance of project participants and contracting
parties in a construction project in each stage influence the project
success
 However, the importance of the final account closing in the stipulated
time frame and agreed contract cost is always being neglected
 Undue protracted inaction makes the closing of final account more
difficult and frequently leads to the emergence of unnecessary
dispute (Duncan Cartlidge, 2009).

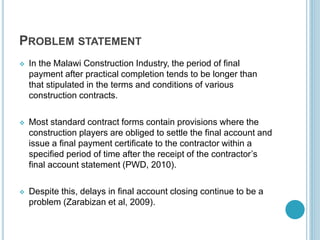

PROBLEM STATEMENT
 In the Malawi Construction Industry, the period of final
payment after practical completion tends to be longer than
that stipulated in the terms and conditions of various
construction contracts.
 Most standard contract forms contain provisions where the
construction players are obliged to settle the final account and
issue a final payment certificate to the contractor within a
specified period of time after the receipt of the contractors
final account statement (PWD, 2010).
 Despite this, delays in final account closing continue to be a
problem (Zarabizan et al, 2009).

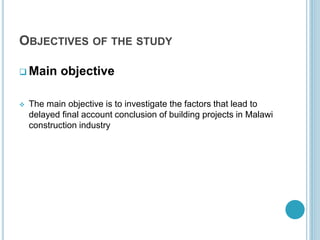

OBJECTIVES OF THE STUDY
 Main objective
 The main objective is to investigate the factors that lead to
delayed final account conclusion of building projects in Malawi
construction industry

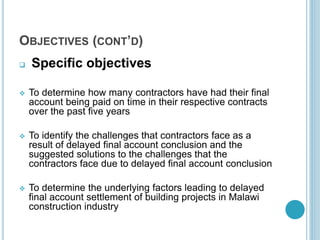

OBJECTIVES (CONTD)
 Specific objectives
 To determine how many contractors have had their final
account being paid on time in their respective contracts
over the past five years
 To identify the challenges that contractors face as a
result of delayed final account conclusion and the
suggested solutions to the challenges that the
contractors face due to delayed final account conclusion
 To determine the underlying factors leading to delayed
final account settlement of building projects in Malawi
construction industry

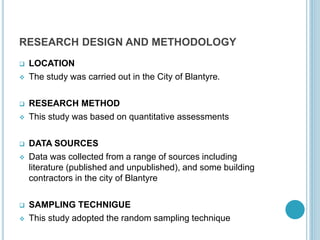

RESEARCH DESIGN AND METHODOLOGY
 LOCATION
 The study was carried out in the City of Blantyre.
 RESEARCH METHOD
 This study was based on quantitative assessments
 DATA SOURCES
 Data was collected from a range of sources including
literature (published and unpublished), and some building
contractors in the city of Blantyre
 SAMPLING TECHNIGUE
 This study adopted the random sampling technique

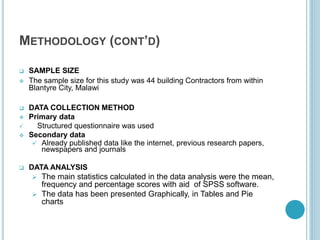

METHODOLOGY (CONTD)
 SAMPLE SIZE
 The sample size for this study was 44 building Contractors from within
Blantyre City, Malawi
 DATA COLLECTION METHOD
 Primary data
 Structured questionnaire was used
 Secondary data
 Already published data like the internet, previous research papers,
newspapers and journals
 DATA ANALYSIS
 The main statistics calculated in the data analysis were the mean,
frequency and percentage scores with aid of SPSS software.
 The data has been presented Graphically, in Tables and Pie
charts

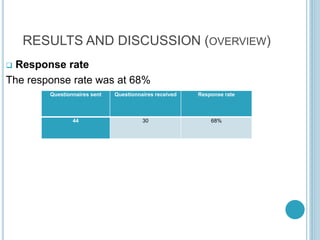

RESULTS AND DISCUSSION (OVERVIEW)
 Response rate
The response rate was at 68%
Questionnaires sent Questionnaires received Response rate
44 30 68%

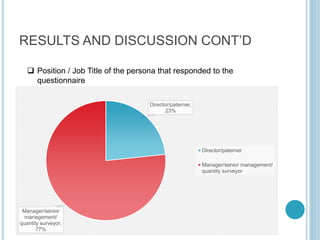

RESULTS AND DISCUSSION CONTD
Director/paterner,
23%
Manager/senior
management/
quantity surveyor,
77%
Director/paterner
Manager/senior management/
quantity surveyor
 Position / Job Title of the persona that responded to the
questionnaire
RESULTS AND DISCUSSION CONTD

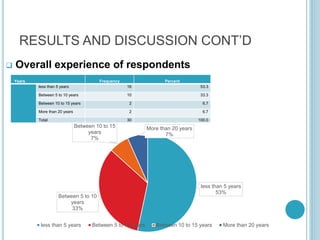

 Overall experience of respondents
less than 5 years
53%
Between 5 to 10
years
33%
Between 10 to 15
years
7%
More than 20 years
7%
less than 5 years Between 5 to 10 years Between 10 to 15 years More than 20 years
Years Frequency Percent
less than 5 years 16 53.3
Between 5 to 10 years 10 33.3
Between 10 to 15 years 2 6.7
More than 20 years 2 6.7
Total 30 100.0
RESULTS AND DISCUSSION CONTD

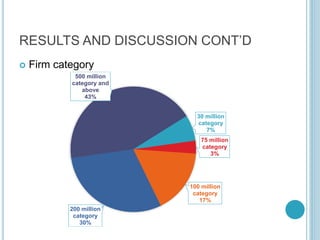

 Firm category
30 million
category
7%
75 million
category
3%
100 million
category
17%
200 million
category
30%
500 million
category and
above
43%
RESULTS AND DISCUSSION CONTD

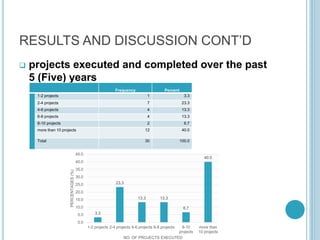

 projects executed and completed over the past
5 (Five) years
Frequency Percent
1-2 projects 1 3.3
2-4 projects 7 23.3
4-6 projects 4 13.3
6-8 projects 4 13.3
8-10 projects 2 6.7
more than 10 projects 12 40.0
Total 30 100.0
3.3
23.3
13.3 13.3
6.7
40.0
0.0
5.0
10.0
15.0
20.0
25.0
30.0
35.0
40.0
45.0
1-2 projects 2-4 projects 4-6 projects 6-8 projects 8-10
projects
more than
10 projects
PERCENTAGES(%)
NO. OF PROJECTS EXECUTED
RESULTS AND DISCUSSION CONTD

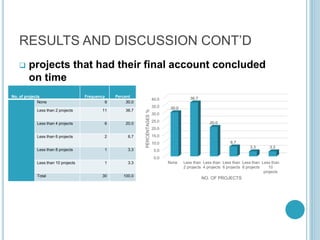

 projects that had their final account concluded
on time
No. of projects Frequency Percent
None 9 30.0
Less than 2 projects 11 36.7
Less than 4 projects 6 20.0
Less than 6 projects 2 6.7
Less than 8 projects 1 3.3
Less than 10 projects 1 3.3
Total 30 100.0
0.0
5.0
10.0
15.0
20.0
25.0
30.0
35.0
40.0
None Less than
2 projects
Less than
4 projects
Less than
6 projects
Less than
8 projects
Less than
10
projects
30.0
36.7
20.0
6.7
3.3 3.3PERCENTAGES%
NO. OF PROJECTS
RESULTS AND DISCUSSION CONTD

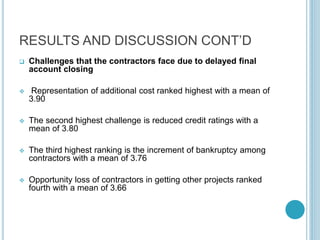

 Challenges that the contractors face due to delayed final
account closing
 Representation of additional cost ranked highest with a mean of
3.90
 The second highest challenge is reduced credit ratings with a
mean of 3.80
 The third highest ranking is the increment of bankruptcy among
contractors with a mean of 3.76
 Opportunity loss of contractors in getting other projects ranked
fourth with a mean of 3.66

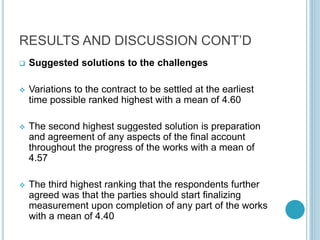

RESULTS AND DISCUSSION CONTD
 Suggested solutions to the challenges
 Variations to the contract to be settled at the earliest
time possible ranked highest with a mean of 4.60
 The second highest suggested solution is preparation
and agreement of any aspects of the final account
throughout the progress of the works with a mean of
4.57
 The third highest ranking that the respondents further
agreed was that the parties should start finalizing
measurement upon completion of any part of the works
with a mean of 4.40
RESULTS AND DISCUSSION CONTD

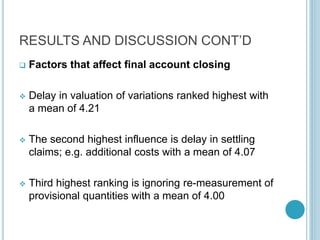

 Factors that affect final account closing
 Delay in valuation of variations ranked highest with
a mean of 4.21
 The second highest influence is delay in settling
claims; e.g. additional costs with a mean of 4.07
 Third highest ranking is ignoring re-measurement of
provisional quantities with a mean of 4.00
RESULTS AND DISCUSSION CONTD

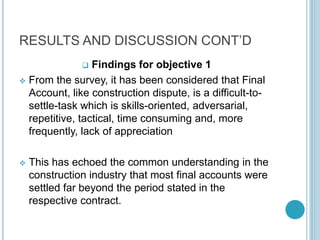

 Findings for objective 1
 From the survey, it has been considered that Final
Account, like construction dispute, is a difficult-to-
settle-task which is skills-oriented, adversarial,
repetitive, tactical, time consuming and, more
frequently, lack of appreciation
 This has echoed the common understanding in the
construction industry that most final accounts were
settled far beyond the period stated in the
respective contract.
RESULTS AND DISCUSSION CONTD

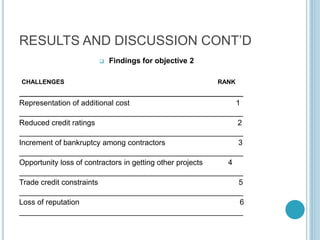

 Findings for objective 2
CHALLENGES RANK
Representation of additional cost 1
Reduced credit ratings 2
Increment of bankruptcy among contractors 3
Opportunity loss of contractors in getting other projects 4
Trade credit constraints 5
Loss of reputation 6
RESULTS AND DISCUSSION CONTD

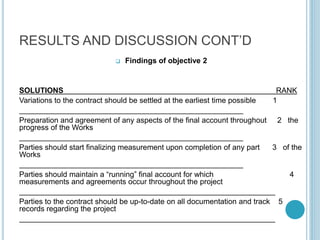

 Findings of objective 2
SOLUTIONS RANK
Variations to the contract should be settled at the earliest time possible 1
Preparation and agreement of any aspects of the final account throughout 2 the
progress of the Works
Parties should start finalizing measurement upon completion of any part 3 of the
Works
Parties should maintain a running final account for which 4
measurements and agreements occur throughout the project
Parties to the contract should be up-to-date on all documentation and track 5
records regarding the project
RESULTS AND DISCUSSION CONTD

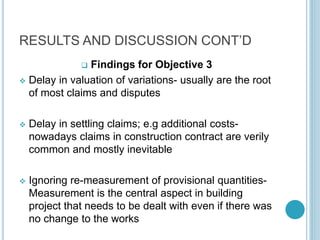

 Findings for Objective 3
 Delay in valuation of variations- usually are the root
of most claims and disputes
 Delay in settling claims; e.g additional costs-
nowadays claims in construction contract are verily
common and mostly inevitable
 Ignoring re-measurement of provisional quantities-
Measurement is the central aspect in building
project that needs to be dealt with even if there was
no change to the works
RESULTS AND DISCUSSION CONTD

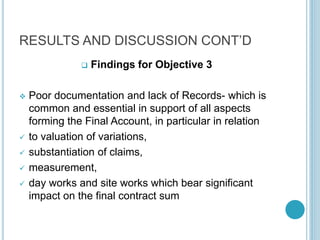

 Findings for Objective 3
 Poor documentation and lack of Records- which is
common and essential in support of all aspects
forming the Final Account, in particular in relation
 to valuation of variations,
 substantiation of claims,
 measurement,
 day works and site works which bear significant
impact on the final contract sum

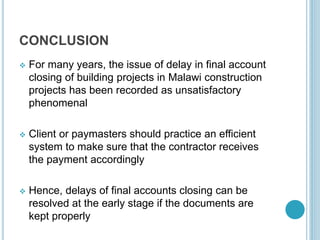

CONCLUSION
 For many years, the issue of delay in final account
closing of building projects in Malawi construction
projects has been recorded as unsatisfactory
phenomenal
 Client or paymasters should practice an efficient
system to make sure that the contractor receives
the payment accordingly
 Hence, delays of final accounts closing can be
resolved at the early stage if the documents are
kept properly

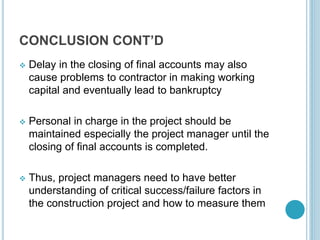

CONCLUSION CONTD
 Delay in the closing of final accounts may also
cause problems to contractor in making working
capital and eventually lead to bankruptcy
 Personal in charge in the project should be
maintained especially the project manager until the
closing of final accounts is completed.
 Thus, project managers need to have better
understanding of critical success/failure factors in
the construction project and how to measure them

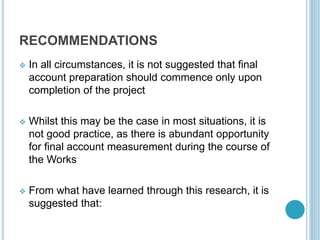

RECOMMENDATIONS
 In all circumstances, it is not suggested that final
account preparation should commence only upon
completion of the project
 Whilst this may be the case in most situations, it is
not good practice, as there is abundant opportunity
for final account measurement during the course of
the Works
 From what have learned through this research, it is
suggested that:

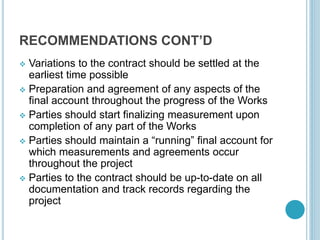

RECOMMENDATIONS CONTD
 Variations to the contract should be settled at the
earliest time possible
 Preparation and agreement of any aspects of the
final account throughout the progress of the Works
 Parties should start finalizing measurement upon
completion of any part of the Works
 Parties should maintain a running final account for
which measurements and agreements occur
throughout the project
 Parties to the contract should be up-to-date on all
documentation and track records regarding the
project
THANK YOU
GOD BLESS YOU
ALL!!!!!!!!
Ad

Recommended

Elemental cost analysis
Elemental cost analysis
fareezsham
Pp2 coursework 2 201808
Pp2 coursework 2 201808
Arissa Loh
element
element
Lai Vlyn
A project report on financial statement analysis
A project report on financial statement analysis
Projects Kart
Managing the Construction Claims Effectively
Managing the Construction Claims Effectively
SHAZEBALIKHAN1
challenges of highway projects in India
challenges of highway projects in India
Sanjay Kedia
Managing Risk of Delay in Construction Projects Erfan & Basharat.pptx
Managing Risk of Delay in Construction Projects Erfan & Basharat.pptx
Subhan634796
Study on the analysis and evaluation of delays in public sector construction ...
Study on the analysis and evaluation of delays in public sector construction ...
IRJET Journal
76 s201905
76 s201905
IJRAT
The pathway to documenting successful contract claims..
The pathway to documenting successful contract claims..
Mohamed Hassanein, BSc , PMP, MBA
Investigation of Time-Cost Effectiveness on Construction Projects
Investigation of Time-Cost Effectiveness on Construction Projects
IOSR Journals
Causes of delays on Construction Projects in Kuwait according to opinion of e...
Causes of delays on Construction Projects in Kuwait according to opinion of e...
IJERA Editor
claims management framework
claims management framework
Mohammad Salama,PMP,PgMP,PMI-SP,PMI-RMP, PMOC
A study on the analysis and evaluation of delays in private construction Proj...
A study on the analysis and evaluation of delays in private construction Proj...
IRJET Journal
MGT 3302, Introduction to Project Management 1 Cou.docx
MGT 3302, Introduction to Project Management 1 Cou.docx
poulterbarbara
Claims
Claims
Mike Debiak
Investigating the impact of payment problem in the context of construction pr...
Investigating the impact of payment problem in the context of construction pr...
Total Assignment Help
Running Head PROJECT MANAGEMENT 5Progress Results and F.docx
Running Head PROJECT MANAGEMENT 5Progress Results and F.docx
jeanettehully
CLOSE PROJECT.pptxsnsnsjsjsjsjsjsjsjsjsjsjsjsjs
CLOSE PROJECT.pptxsnsnsjsjsjsjsjsjsjsjsjsjsjsjs
BinteAnwar3
Extensions of Time - Contract Management
Extensions of Time - Contract Management
brainquisitive
Analysis of factors contributing delays and claims in
Analysis of factors contributing delays and claims in
eSAT Publishing House
Analysis of factors contributing delays and claims in construction projects
Analysis of factors contributing delays and claims in construction projects
eSAT Journals
Analysis of factors contributing delays and claims in construction projects
Analysis of factors contributing delays and claims in construction projects
eSAT Journals
Project management lecture 11 slide 11
Project management lecture 11 slide 11
beautyshine
Research proposal implementation of project management
Research proposal implementation of project management
Tutors India
Project management in construction
Project management in construction
NAVNEET KUMAR JHA
Project closure
Project closure
Gyaneshwar Suman
IRJET- Delay in Construction its Causes and Mitigation: A Review
IRJET- Delay in Construction its Causes and Mitigation: A Review
IRJET Journal
Rapid Prototyping for XR: Lecture 6 - AI for Prototyping and Research Directi...
Rapid Prototyping for XR: Lecture 6 - AI for Prototyping and Research Directi...
Mark Billinghurst
IPL_Logic_Flow.pdf Mainframe IPLMainframe IPL
IPL_Logic_Flow.pdf Mainframe IPLMainframe IPL
KhadijaKhadijaAouadi

More Related Content

Similar to FINAL ACCOUNT CONCLUSION OF BUILDING PROJECTS (20)

76 s201905
76 s201905
IJRAT
The pathway to documenting successful contract claims..
The pathway to documenting successful contract claims..
Mohamed Hassanein, BSc , PMP, MBA
Investigation of Time-Cost Effectiveness on Construction Projects
Investigation of Time-Cost Effectiveness on Construction Projects
IOSR Journals
Causes of delays on Construction Projects in Kuwait according to opinion of e...
Causes of delays on Construction Projects in Kuwait according to opinion of e...
IJERA Editor
claims management framework
claims management framework
Mohammad Salama,PMP,PgMP,PMI-SP,PMI-RMP, PMOC
A study on the analysis and evaluation of delays in private construction Proj...
A study on the analysis and evaluation of delays in private construction Proj...
IRJET Journal
MGT 3302, Introduction to Project Management 1 Cou.docx
MGT 3302, Introduction to Project Management 1 Cou.docx
poulterbarbara
Claims
Claims
Mike Debiak
Investigating the impact of payment problem in the context of construction pr...
Investigating the impact of payment problem in the context of construction pr...
Total Assignment Help
Running Head PROJECT MANAGEMENT 5Progress Results and F.docx
Running Head PROJECT MANAGEMENT 5Progress Results and F.docx
jeanettehully
CLOSE PROJECT.pptxsnsnsjsjsjsjsjsjsjsjsjsjsjsjs
CLOSE PROJECT.pptxsnsnsjsjsjsjsjsjsjsjsjsjsjsjs
BinteAnwar3
Extensions of Time - Contract Management
Extensions of Time - Contract Management
brainquisitive
Analysis of factors contributing delays and claims in
Analysis of factors contributing delays and claims in
eSAT Publishing House
Analysis of factors contributing delays and claims in construction projects
Analysis of factors contributing delays and claims in construction projects
eSAT Journals
Analysis of factors contributing delays and claims in construction projects
Analysis of factors contributing delays and claims in construction projects
eSAT Journals
Project management lecture 11 slide 11
Project management lecture 11 slide 11
beautyshine
Research proposal implementation of project management
Research proposal implementation of project management
Tutors India
Project management in construction
Project management in construction
NAVNEET KUMAR JHA
Project closure
Project closure
Gyaneshwar Suman
IRJET- Delay in Construction its Causes and Mitigation: A Review
IRJET- Delay in Construction its Causes and Mitigation: A Review
IRJET Journal
76 s201905
76 s201905
IJRAT
Investigation of Time-Cost Effectiveness on Construction Projects
Investigation of Time-Cost Effectiveness on Construction Projects
IOSR Journals
Causes of delays on Construction Projects in Kuwait according to opinion of e...
Causes of delays on Construction Projects in Kuwait according to opinion of e...
IJERA Editor
A study on the analysis and evaluation of delays in private construction Proj...
A study on the analysis and evaluation of delays in private construction Proj...
IRJET Journal
MGT 3302, Introduction to Project Management 1 Cou.docx
MGT 3302, Introduction to Project Management 1 Cou.docx
poulterbarbara
Investigating the impact of payment problem in the context of construction pr...
Investigating the impact of payment problem in the context of construction pr...
Total Assignment Help
Running Head PROJECT MANAGEMENT 5Progress Results and F.docx
Running Head PROJECT MANAGEMENT 5Progress Results and F.docx
jeanettehully
CLOSE PROJECT.pptxsnsnsjsjsjsjsjsjsjsjsjsjsjsjs
CLOSE PROJECT.pptxsnsnsjsjsjsjsjsjsjsjsjsjsjsjs
BinteAnwar3
Extensions of Time - Contract Management
Extensions of Time - Contract Management
brainquisitive
Analysis of factors contributing delays and claims in
Analysis of factors contributing delays and claims in
eSAT Publishing House
Analysis of factors contributing delays and claims in construction projects
Analysis of factors contributing delays and claims in construction projects
eSAT Journals
Analysis of factors contributing delays and claims in construction projects
Analysis of factors contributing delays and claims in construction projects
eSAT Journals
Project management lecture 11 slide 11
Project management lecture 11 slide 11
beautyshine
Research proposal implementation of project management
Research proposal implementation of project management
Tutors India
Project management in construction
Project management in construction
NAVNEET KUMAR JHA
IRJET- Delay in Construction its Causes and Mitigation: A Review
IRJET- Delay in Construction its Causes and Mitigation: A Review
IRJET Journal

Recently uploaded (20)

Rapid Prototyping for XR: Lecture 6 - AI for Prototyping and Research Directi...
Rapid Prototyping for XR: Lecture 6 - AI for Prototyping and Research Directi...
Mark Billinghurst
IPL_Logic_Flow.pdf Mainframe IPLMainframe IPL
IPL_Logic_Flow.pdf Mainframe IPLMainframe IPL
KhadijaKhadijaAouadi
Introduction to Natural Language Processing - Stages in NLP Pipeline, Challen...
Introduction to Natural Language Processing - Stages in NLP Pipeline, Challen...
resming1
International Journal of Advanced Information Technology (IJAIT)
International Journal of Advanced Information Technology (IJAIT)
ijait
Machine Learning - Classification Algorithms
Machine Learning - Classification Algorithms
resming1
Abraham Silberschatz-Operating System Concepts (9th,2012.12).pdf
Abraham Silberschatz-Operating System Concepts (9th,2012.12).pdf
Shabista Imam
Rapid Prototyping for XR: Lecture 1 Introduction to Prototyping
Rapid Prototyping for XR: Lecture 1 Introduction to Prototyping
Mark Billinghurst
Mechanical Vibration_MIC 202_iit roorkee.pdf
Mechanical Vibration_MIC 202_iit roorkee.pdf
isahiliitr
Generative AI & Scientific Research : Catalyst for Innovation, Ethics & Impact
Generative AI & Scientific Research : Catalyst for Innovation, Ethics & Impact
AlqualsaDIResearchGr
Tally.ERP 9 at a Glance.book - Tally Solutions .pdf
Tally.ERP 9 at a Glance.book - Tally Solutions .pdf
Shabista Imam
Deep Learning for Image Processing on 16 June 2025 MITS.pptx
Deep Learning for Image Processing on 16 June 2025 MITS.pptx
resming1
System design handwritten notes guidance
System design handwritten notes guidance
Shabista Imam
machine learning is a advance technology
machine learning is a advance technology
ynancy893
Complete guidance book of Asp.Net Web API
Complete guidance book of Asp.Net Web API
Shabista Imam
(Continuous Integration and Continuous Deployment/Delivery) is a fundamental ...
(Continuous Integration and Continuous Deployment/Delivery) is a fundamental ...
ketan09101
20CE404-Soil Mechanics - 際際滷 Share PPT
20CE404-Soil Mechanics - 際際滷 Share PPT
saravananr808639
Deep Learning for Natural Language Processing_FDP on 16 June 2025 MITS.pptx
Deep Learning for Natural Language Processing_FDP on 16 June 2025 MITS.pptx
resming1
Rapid Prototyping for XR: Lecture 4 - High Level Prototyping.
Rapid Prototyping for XR: Lecture 4 - High Level Prototyping.
Mark Billinghurst
Structured Programming with C++ :: Kjell Backman
Structured Programming with C++ :: Kjell Backman
Shabista Imam
special_edition_using_visual_foxpro_6.pdf
special_edition_using_visual_foxpro_6.pdf
Shabista Imam
Rapid Prototyping for XR: Lecture 6 - AI for Prototyping and Research Directi...
Rapid Prototyping for XR: Lecture 6 - AI for Prototyping and Research Directi...
Mark Billinghurst
IPL_Logic_Flow.pdf Mainframe IPLMainframe IPL
IPL_Logic_Flow.pdf Mainframe IPLMainframe IPL
KhadijaKhadijaAouadi
Introduction to Natural Language Processing - Stages in NLP Pipeline, Challen...
Introduction to Natural Language Processing - Stages in NLP Pipeline, Challen...
resming1
International Journal of Advanced Information Technology (IJAIT)
International Journal of Advanced Information Technology (IJAIT)
ijait
Machine Learning - Classification Algorithms
Machine Learning - Classification Algorithms
resming1
Abraham Silberschatz-Operating System Concepts (9th,2012.12).pdf
Abraham Silberschatz-Operating System Concepts (9th,2012.12).pdf
Shabista Imam
Rapid Prototyping for XR: Lecture 1 Introduction to Prototyping
Rapid Prototyping for XR: Lecture 1 Introduction to Prototyping
Mark Billinghurst
Mechanical Vibration_MIC 202_iit roorkee.pdf
Mechanical Vibration_MIC 202_iit roorkee.pdf
isahiliitr
Generative AI & Scientific Research : Catalyst for Innovation, Ethics & Impact
Generative AI & Scientific Research : Catalyst for Innovation, Ethics & Impact
AlqualsaDIResearchGr
Tally.ERP 9 at a Glance.book - Tally Solutions .pdf
Tally.ERP 9 at a Glance.book - Tally Solutions .pdf
Shabista Imam
Deep Learning for Image Processing on 16 June 2025 MITS.pptx
Deep Learning for Image Processing on 16 June 2025 MITS.pptx
resming1
System design handwritten notes guidance
System design handwritten notes guidance
Shabista Imam
machine learning is a advance technology
machine learning is a advance technology
ynancy893
Complete guidance book of Asp.Net Web API
Complete guidance book of Asp.Net Web API
Shabista Imam
(Continuous Integration and Continuous Deployment/Delivery) is a fundamental ...
(Continuous Integration and Continuous Deployment/Delivery) is a fundamental ...
ketan09101
20CE404-Soil Mechanics - 際際滷 Share PPT
20CE404-Soil Mechanics - 際際滷 Share PPT
saravananr808639
Deep Learning for Natural Language Processing_FDP on 16 June 2025 MITS.pptx
Deep Learning for Natural Language Processing_FDP on 16 June 2025 MITS.pptx
resming1
Rapid Prototyping for XR: Lecture 4 - High Level Prototyping.
Rapid Prototyping for XR: Lecture 4 - High Level Prototyping.
Mark Billinghurst
Structured Programming with C++ :: Kjell Backman
Structured Programming with C++ :: Kjell Backman
Shabista Imam
special_edition_using_visual_foxpro_6.pdf
special_edition_using_visual_foxpro_6.pdf
Shabista Imam
Ad

FINAL ACCOUNT CONCLUSION OF BUILDING PROJECTS

  • 1. PROJECT TITLE AN INVESTIGATION OF FACTORS THAT LEAD TO DELAYED FINAL ACCOUNT CONCLUSION OF BUILDING PROJECTS IN MALAWI CONSTRUCTION INDUSTRY BY: LENSON MHANGO (BQS/09/PE/016) SUPERVISED BY: MR. C.I.M. CHIOCHA
  • 2. PRESENTATION OUTLINE Introduction Problem Statement Objectives of the study Research design and Methodology Results and Discussion Conclusion and Recommendation
  • 3. INTRODUCTION Delay can be defined as time overrun or extension of time to complete the project. There are high possibilities that delay issues in final account closing cannot be avoided in Malawi construction industry Delay in final account closing is a situation when the actual planning (time and budget allocation) of a construction project exceeds the planned schedule or on the other hand, final account closing exceeds the time and other provisions specified in the contract (Zarabizan et al., 2009). Final Account is taken in the construction contracts simply as a mechanism for dealing with the final contract sum or final payment due to the Contractor after the Final Measurement Period or after the Maintenance / Defects Liability Period
  • 4. INTRODUCTION (CONTD) Construction projects generally comprise five stages(Rumus, Birchall, Griffiths, 2008): initiation/planning, design, tender, construction and final account/defect liability stage
  • 5. INTRODUCTION (CONTD) The role and performance of project participants and contracting parties in a construction project in each stage influence the project success However, the importance of the final account closing in the stipulated time frame and agreed contract cost is always being neglected Undue protracted inaction makes the closing of final account more difficult and frequently leads to the emergence of unnecessary dispute (Duncan Cartlidge, 2009).
  • 6. PROBLEM STATEMENT In the Malawi Construction Industry, the period of final payment after practical completion tends to be longer than that stipulated in the terms and conditions of various construction contracts. Most standard contract forms contain provisions where the construction players are obliged to settle the final account and issue a final payment certificate to the contractor within a specified period of time after the receipt of the contractors final account statement (PWD, 2010). Despite this, delays in final account closing continue to be a problem (Zarabizan et al, 2009).
  • 7. OBJECTIVES OF THE STUDY Main objective The main objective is to investigate the factors that lead to delayed final account conclusion of building projects in Malawi construction industry
  • 8. OBJECTIVES (CONTD) Specific objectives To determine how many contractors have had their final account being paid on time in their respective contracts over the past five years To identify the challenges that contractors face as a result of delayed final account conclusion and the suggested solutions to the challenges that the contractors face due to delayed final account conclusion To determine the underlying factors leading to delayed final account settlement of building projects in Malawi construction industry
  • 9. RESEARCH DESIGN AND METHODOLOGY LOCATION The study was carried out in the City of Blantyre. RESEARCH METHOD This study was based on quantitative assessments DATA SOURCES Data was collected from a range of sources including literature (published and unpublished), and some building contractors in the city of Blantyre SAMPLING TECHNIGUE This study adopted the random sampling technique
  • 10. METHODOLOGY (CONTD) SAMPLE SIZE The sample size for this study was 44 building Contractors from within Blantyre City, Malawi DATA COLLECTION METHOD Primary data Structured questionnaire was used Secondary data Already published data like the internet, previous research papers, newspapers and journals DATA ANALYSIS The main statistics calculated in the data analysis were the mean, frequency and percentage scores with aid of SPSS software. The data has been presented Graphically, in Tables and Pie charts
  • 11. RESULTS AND DISCUSSION (OVERVIEW) Response rate The response rate was at 68% Questionnaires sent Questionnaires received Response rate 44 30 68%
  • 12. RESULTS AND DISCUSSION CONTD Director/paterner, 23% Manager/senior management/ quantity surveyor, 77% Director/paterner Manager/senior management/ quantity surveyor Position / Job Title of the persona that responded to the questionnaire
  • 13. RESULTS AND DISCUSSION CONTD Overall experience of respondents less than 5 years 53% Between 5 to 10 years 33% Between 10 to 15 years 7% More than 20 years 7% less than 5 years Between 5 to 10 years Between 10 to 15 years More than 20 years Years Frequency Percent less than 5 years 16 53.3 Between 5 to 10 years 10 33.3 Between 10 to 15 years 2 6.7 More than 20 years 2 6.7 Total 30 100.0
  • 14. RESULTS AND DISCUSSION CONTD Firm category 30 million category 7% 75 million category 3% 100 million category 17% 200 million category 30% 500 million category and above 43%
  • 15. RESULTS AND DISCUSSION CONTD projects executed and completed over the past 5 (Five) years Frequency Percent 1-2 projects 1 3.3 2-4 projects 7 23.3 4-6 projects 4 13.3 6-8 projects 4 13.3 8-10 projects 2 6.7 more than 10 projects 12 40.0 Total 30 100.0 3.3 23.3 13.3 13.3 6.7 40.0 0.0 5.0 10.0 15.0 20.0 25.0 30.0 35.0 40.0 45.0 1-2 projects 2-4 projects 4-6 projects 6-8 projects 8-10 projects more than 10 projects PERCENTAGES(%) NO. OF PROJECTS EXECUTED
  • 16. RESULTS AND DISCUSSION CONTD projects that had their final account concluded on time No. of projects Frequency Percent None 9 30.0 Less than 2 projects 11 36.7 Less than 4 projects 6 20.0 Less than 6 projects 2 6.7 Less than 8 projects 1 3.3 Less than 10 projects 1 3.3 Total 30 100.0 0.0 5.0 10.0 15.0 20.0 25.0 30.0 35.0 40.0 None Less than 2 projects Less than 4 projects Less than 6 projects Less than 8 projects Less than 10 projects 30.0 36.7 20.0 6.7 3.3 3.3PERCENTAGES% NO. OF PROJECTS
  • 17. RESULTS AND DISCUSSION CONTD Challenges that the contractors face due to delayed final account closing Representation of additional cost ranked highest with a mean of 3.90 The second highest challenge is reduced credit ratings with a mean of 3.80 The third highest ranking is the increment of bankruptcy among contractors with a mean of 3.76 Opportunity loss of contractors in getting other projects ranked fourth with a mean of 3.66
  • 18. RESULTS AND DISCUSSION CONTD Suggested solutions to the challenges Variations to the contract to be settled at the earliest time possible ranked highest with a mean of 4.60 The second highest suggested solution is preparation and agreement of any aspects of the final account throughout the progress of the works with a mean of 4.57 The third highest ranking that the respondents further agreed was that the parties should start finalizing measurement upon completion of any part of the works with a mean of 4.40
  • 19. RESULTS AND DISCUSSION CONTD Factors that affect final account closing Delay in valuation of variations ranked highest with a mean of 4.21 The second highest influence is delay in settling claims; e.g. additional costs with a mean of 4.07 Third highest ranking is ignoring re-measurement of provisional quantities with a mean of 4.00
  • 20. RESULTS AND DISCUSSION CONTD Findings for objective 1 From the survey, it has been considered that Final Account, like construction dispute, is a difficult-to- settle-task which is skills-oriented, adversarial, repetitive, tactical, time consuming and, more frequently, lack of appreciation This has echoed the common understanding in the construction industry that most final accounts were settled far beyond the period stated in the respective contract.
  • 21. RESULTS AND DISCUSSION CONTD Findings for objective 2 CHALLENGES RANK Representation of additional cost 1 Reduced credit ratings 2 Increment of bankruptcy among contractors 3 Opportunity loss of contractors in getting other projects 4 Trade credit constraints 5 Loss of reputation 6
  • 22. RESULTS AND DISCUSSION CONTD Findings of objective 2 SOLUTIONS RANK Variations to the contract should be settled at the earliest time possible 1 Preparation and agreement of any aspects of the final account throughout 2 the progress of the Works Parties should start finalizing measurement upon completion of any part 3 of the Works Parties should maintain a running final account for which 4 measurements and agreements occur throughout the project Parties to the contract should be up-to-date on all documentation and track 5 records regarding the project
  • 23. RESULTS AND DISCUSSION CONTD Findings for Objective 3 Delay in valuation of variations- usually are the root of most claims and disputes Delay in settling claims; e.g additional costs- nowadays claims in construction contract are verily common and mostly inevitable Ignoring re-measurement of provisional quantities- Measurement is the central aspect in building project that needs to be dealt with even if there was no change to the works
  • 24. RESULTS AND DISCUSSION CONTD Findings for Objective 3 Poor documentation and lack of Records- which is common and essential in support of all aspects forming the Final Account, in particular in relation to valuation of variations, substantiation of claims, measurement, day works and site works which bear significant impact on the final contract sum
  • 25. CONCLUSION For many years, the issue of delay in final account closing of building projects in Malawi construction projects has been recorded as unsatisfactory phenomenal Client or paymasters should practice an efficient system to make sure that the contractor receives the payment accordingly Hence, delays of final accounts closing can be resolved at the early stage if the documents are kept properly
  • 26. CONCLUSION CONTD Delay in the closing of final accounts may also cause problems to contractor in making working capital and eventually lead to bankruptcy Personal in charge in the project should be maintained especially the project manager until the closing of final accounts is completed. Thus, project managers need to have better understanding of critical success/failure factors in the construction project and how to measure them
  • 27. RECOMMENDATIONS In all circumstances, it is not suggested that final account preparation should commence only upon completion of the project Whilst this may be the case in most situations, it is not good practice, as there is abundant opportunity for final account measurement during the course of the Works From what have learned through this research, it is suggested that:
  • 28. RECOMMENDATIONS CONTD Variations to the contract should be settled at the earliest time possible Preparation and agreement of any aspects of the final account throughout the progress of the Works Parties should start finalizing measurement upon completion of any part of the Works Parties should maintain a running final account for which measurements and agreements occur throughout the project Parties to the contract should be up-to-date on all documentation and track records regarding the project
  • 29. THANK YOU GOD BLESS YOU ALL!!!!!!!!
