METHOD STATEMENT
Table of contents
of
LEAN CONCRETE
for
BUILDING WORKS

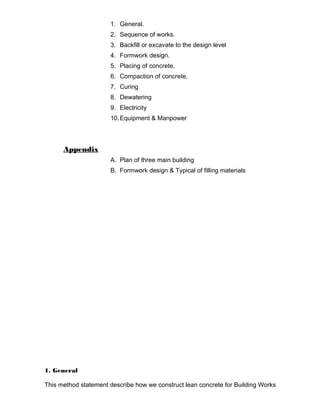

1. General.
2. Sequence of works.
3. Backfill or excavate to the design level
4. Formwork design.
5. Placing of concrete.
6. Compaction of concrete.
7. Curing
8. Dewatering
9. Electricity
10.Equipment & Manpower
Appendix
A. Plan of three main building
B. Formwork design & Typical of filling materials
1. General
This method statement describe how we construct lean concrete for Building Works

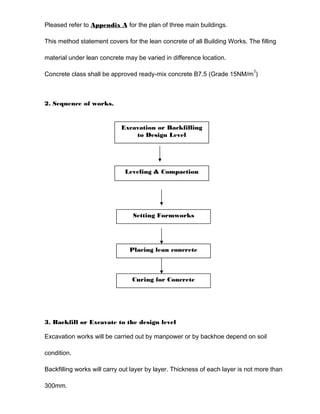

Pleased refer to Appendix A for the plan of three main buildings.
This method statement covers for the lean concrete of all Building Works. The filling
material under lean concrete may be varied in difference location.
Concrete class shall be approved ready-mix concrete B7.5 (Grade 15NM/m2)
Excavation or Backfilling
to Design Level
2. Sequence of works.
Leveling & Compaction
Setting Formworks
Placing lean concrete
Curing for Concrete
3. Backfill or Excavate to the design level
Excavation works will be carried out by manpower or by backhoe depend on soil
condition.
Backfilling works will carry out layer by layer. Thickness of each layer is not more than
300mm.

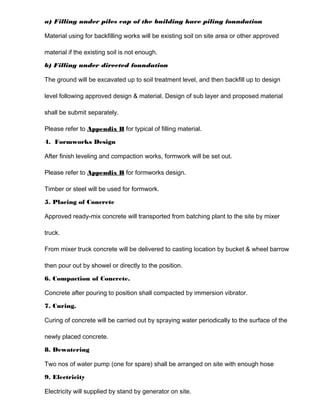

a) Filling under piles cap of the building have piling foundation
Material using for backfilling works will be existing soil on site area or other approved
material if the existing soil is not enough.
b) Filling under directed foundation
The ground will be excavated up to soil treatment level, and then backfill up to design
level following approved design & material. Design of sub layer and proposed material
shall be submit separately.
Please refer to Appendix B for typical of filling material.
4. Formworks Design
After finish leveling and compaction works, formwork will be set out.
Please refer to Appendix B for formworks design.
Timber or steel will be used for formwork.
5. Placing of Concrete
Approved ready-mix concrete will transported from batching plant to the site by mixer
truck.
From mixer truck concrete will be delivered to casting location by bucket & wheel barrow
then pour out by showel or directly to the position.
6. Compaction of Concrete.
Concrete after pouring to position shall compacted by immersion vibrator.
7. Curing.
Curing of concrete will be carried out by spraying water periodically to the surface of the
newly placed concrete.
8. Dewatering
Two nos of water pump (one for spare) shall be arranged on site with enough hose
9. Electricity
Electricity will supplied by stand by generator on site.
10. Equipment & Manpower

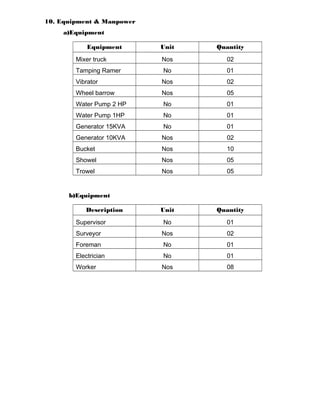

a)Equipment
Equipment Unit Quantity
Mixer truck Nos 02
Tamping Ramer No 01
Vibrator Nos 02
Wheel barrow Nos 05
Water Pump 2 HP No 01
Water Pump 1HP No 01
Generator 15KVA No 01
Generator 10KVA Nos 02
Bucket Nos 10
Showel Nos 05
Trowel Nos 05
b)Equipment
Description Unit Quantity
Supervisor No 01
Surveyor Nos 02
Foreman No 01
Electrician No 01
Worker Nos 08
APPENDIX A
FOUNDATION PLAN OF THREE MAIN BUILDING

APPENDIX B
FORMWORK DESIGN & TYPICAL OF FILLING
MATERIAL

More Related Content

What's hot (20)

DOCX
Method statement for structure excavation
Al-Amin Ahmed Nabin
DOC
Method statement for structural concrete repair rev.0
Minh Bui Si
DOC
Method statement for repair of concrete surface
Minh Bui Si
PPTX
Spun pile
Wen Crystal
PPTX
Post tensioning
SAIV Exports
DOC
Building work method statement cm - ms- bw - 001
Minh Bui Si
PPT
L#8 batching,mixing
Mir Zafarullah
PDF
Formwork Design-Introduction.pdf
sumitt6_25730773
PDF
Compressivestrength concrete
Ar. Bhanu Pratap
PDF
Method statement for civil works
Muhammad Shahid
PDF
Method of Statement - Pavement works
Mohd Nizam Mohd Zan
DOCX
Method statement honycomb repairing
Bharatha Rathnayke
DOCX
02 - Method Statement for Concrete pouring.docx
RAHEEL KHALID
PDF
Steel Structural Design Manual for Engineers
Prem Chand Sharma
PPTX
Design of floor slab
sathananthankartheep
PDF
15.2.2 bored pile wall - method statement
NECB
PPS
Membrane - Plate - Shell
neikrof
PPTX
AITC Shear Wall Design Procedure (20151106)
Fawad Najam
PDF
Retrofit Isolated Footing by: Concrete Jaking Combind Strap Mat Mecro...
Dr.Youssef Hammida
DOC
Excavation method rectified 13-11-2010
Minh Bui Si
Method statement for structure excavation
Al-Amin Ahmed Nabin
Method statement for structural concrete repair rev.0
Minh Bui Si
Method statement for repair of concrete surface
Minh Bui Si
Spun pile
Wen Crystal
Post tensioning
SAIV Exports
Building work method statement cm - ms- bw - 001
Minh Bui Si
L#8 batching,mixing
Mir Zafarullah
Formwork Design-Introduction.pdf
sumitt6_25730773
Compressivestrength concrete
Ar. Bhanu Pratap
Method statement for civil works
Muhammad Shahid
Method of Statement - Pavement works
Mohd Nizam Mohd Zan
Method statement honycomb repairing
Bharatha Rathnayke
02 - Method Statement for Concrete pouring.docx
RAHEEL KHALID
Steel Structural Design Manual for Engineers
Prem Chand Sharma
Design of floor slab
sathananthankartheep
15.2.2 bored pile wall - method statement
NECB
Membrane - Plate - Shell
neikrof
AITC Shear Wall Design Procedure (20151106)
Fawad Najam
Retrofit Isolated Footing by: Concrete Jaking Combind Strap Mat Mecro...
Dr.Youssef Hammida
Excavation method rectified 13-11-2010
Minh Bui Si

Viewers also liked (6)

DOC
Column & beam
Minh Bui Si
PDF
Method aluminum door & window
Minh Bui Si
DOC
Concreting of super structure
Minh Bui Si
DOC
Concrete method rev02
Minh Bui Si
DOC
Method painting works emulsion paint
Minh Bui Si
DOC
Static load test method statement cm - ms- bw - 003
Minh Bui Si
Column & beam
Minh Bui Si
Method aluminum door & window
Minh Bui Si
Concreting of super structure
Minh Bui Si
Concrete method rev02
Minh Bui Si
Method painting works emulsion paint
Minh Bui Si
Static load test method statement cm - ms- bw - 003
Minh Bui Si
Ad

Similar to Method stm lean concrete (20)

PDF
civil enginnering industrial training report
KRISHNA MURARI
PDF
civil enginnering industrial training report
KRISHNA MURARI
DOCX
Site visit report
Wen Crystal
PPT
07. BRIDGE CONSTRUCTION METHODS Precast bridge construction
GokulKannan194051
PPTX
kuku.pptx
JaiminTandel1
PDF
Buildingworkmethodstatement cm-ms-bw-001-141120013134-conversion-gate01(1)
Krm Chari
DOCX
Bored cast insitu
LingWei11
PPTX
Ppt of design of dams
sarojkhadka059
PPT
BFC 31802 Chapter 4a - Copy.ppt
ArdeeArdee
PPT
Construction basic SIP
Mkh Nantu
PDF
Water proofing treatement
Rajiva Gupta
PDF
Irs concrete bridge code
Ajay Kumar
PPT
concrete materials in constructions .ppt
assefatekla5
PPTX
accelerated bridge construction(ABC)
varun km
PPTX
Metroppt
Deepak Siddavaram
PPTX
Final PPT internship 4th year civil .pptx
Rajesh Jangir
PDF
12 fundamentals for_seismic_design_of_rcc_buildings_by_prof_arya
imaduddin91
PPTX
Overhead transmission lines_ Foundation.pptx
EdlirPeci1
PPTX
Dda training presentation
AKASHGARG131
PPTX
RE-DEVELOPMENT WORKS AT EAST KIDWAI NAGAR, NEW
Jaspreet singh
civil enginnering industrial training report
KRISHNA MURARI
civil enginnering industrial training report
KRISHNA MURARI
Site visit report
Wen Crystal
07. BRIDGE CONSTRUCTION METHODS Precast bridge construction
GokulKannan194051
kuku.pptx
JaiminTandel1
Buildingworkmethodstatement cm-ms-bw-001-141120013134-conversion-gate01(1)
Krm Chari
Bored cast insitu
LingWei11
Ppt of design of dams
sarojkhadka059
BFC 31802 Chapter 4a - Copy.ppt
ArdeeArdee
Construction basic SIP
Mkh Nantu
Water proofing treatement
Rajiva Gupta
Irs concrete bridge code
Ajay Kumar
concrete materials in constructions .ppt
assefatekla5
accelerated bridge construction(ABC)
varun km
Final PPT internship 4th year civil .pptx
Rajesh Jangir
12 fundamentals for_seismic_design_of_rcc_buildings_by_prof_arya
imaduddin91
Overhead transmission lines_ Foundation.pptx
EdlirPeci1
Dda training presentation
AKASHGARG131
RE-DEVELOPMENT WORKS AT EAST KIDWAI NAGAR, NEW
Jaspreet singh
Ad

Method stm lean concrete

  • 1. METHOD STATEMENT Table of contents of LEAN CONCRETE for BUILDING WORKS
  • 2. 1. General. 2. Sequence of works. 3. Backfill or excavate to the design level 4. Formwork design. 5. Placing of concrete. 6. Compaction of concrete. 7. Curing 8. Dewatering 9. Electricity 10.Equipment & Manpower Appendix A. Plan of three main building B. Formwork design & Typical of filling materials 1. General This method statement describe how we construct lean concrete for Building Works
  • 3. Pleased refer to Appendix A for the plan of three main buildings. This method statement covers for the lean concrete of all Building Works. The filling material under lean concrete may be varied in difference location. Concrete class shall be approved ready-mix concrete B7.5 (Grade 15NM/m2) Excavation or Backfilling to Design Level 2. Sequence of works. Leveling & Compaction Setting Formworks Placing lean concrete Curing for Concrete 3. Backfill or Excavate to the design level Excavation works will be carried out by manpower or by backhoe depend on soil condition. Backfilling works will carry out layer by layer. Thickness of each layer is not more than 300mm.
  • 4. a) Filling under piles cap of the building have piling foundation Material using for backfilling works will be existing soil on site area or other approved material if the existing soil is not enough. b) Filling under directed foundation The ground will be excavated up to soil treatment level, and then backfill up to design level following approved design & material. Design of sub layer and proposed material shall be submit separately. Please refer to Appendix B for typical of filling material. 4. Formworks Design After finish leveling and compaction works, formwork will be set out. Please refer to Appendix B for formworks design. Timber or steel will be used for formwork. 5. Placing of Concrete Approved ready-mix concrete will transported from batching plant to the site by mixer truck. From mixer truck concrete will be delivered to casting location by bucket & wheel barrow then pour out by showel or directly to the position. 6. Compaction of Concrete. Concrete after pouring to position shall compacted by immersion vibrator. 7. Curing. Curing of concrete will be carried out by spraying water periodically to the surface of the newly placed concrete. 8. Dewatering Two nos of water pump (one for spare) shall be arranged on site with enough hose 9. Electricity Electricity will supplied by stand by generator on site.
  • 5. 10. Equipment & Manpower a)Equipment Equipment Unit Quantity Mixer truck Nos 02 Tamping Ramer No 01 Vibrator Nos 02 Wheel barrow Nos 05 Water Pump 2 HP No 01 Water Pump 1HP No 01 Generator 15KVA No 01 Generator 10KVA Nos 02 Bucket Nos 10 Showel Nos 05 Trowel Nos 05 b)Equipment Description Unit Quantity Supervisor No 01 Surveyor Nos 02 Foreman No 01 Electrician No 01 Worker Nos 08
  • 7. FOUNDATION PLAN OF THREE MAIN BUILDING
  • 8. APPENDIX B FORMWORK DESIGN & TYPICAL OF FILLING MATERIAL
