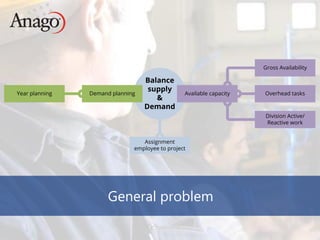

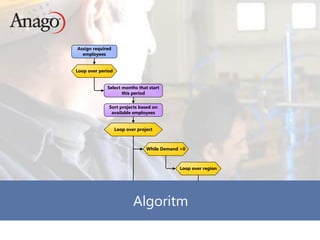

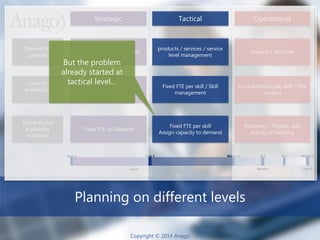

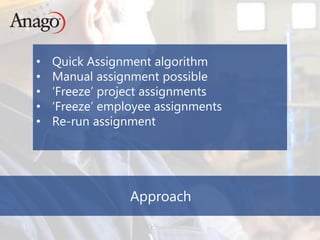

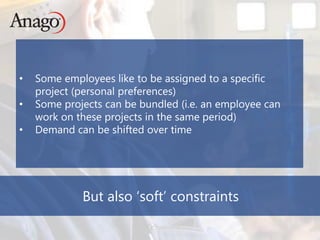

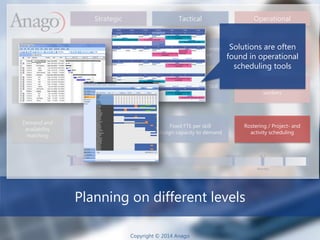

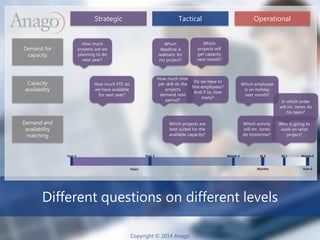

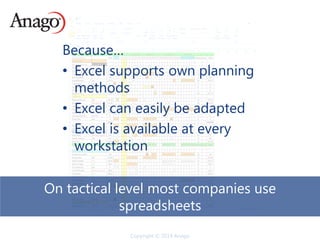

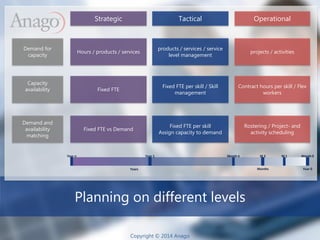

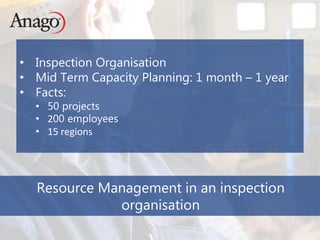

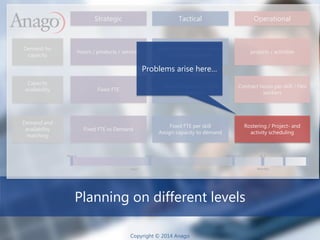

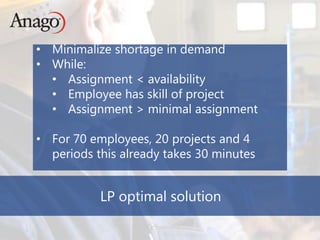

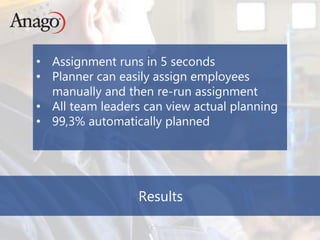

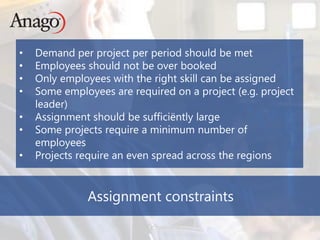

This document discusses resource management and planning in an inspection organization. It describes three levels of planning: strategic, tactical, and operational. Tactical planning occurs on a 1 month to 1 year timeframe and involves balancing supply and demand of employees and assigning employees to projects. Most companies use spreadsheets for tactical planning, but this can cause errors and lack connectivity. The document presents a case study of a inspection organization with 50 projects, 200 employees, and 15 regions. It describes constraints in assigning employees to projects and presents an algorithmic approach and demo tool to quickly assign employees while meeting constraints.
